Project Schedule

The I-175 Action Plan began in January 2025, and is planned to be completed by the end of 2026. The project activities include collecting information, defining a vision for the corridor, and developing corridor alternatives. Please see the project schedule below.

Send Us Your Comments

Your comments are very important. You may send us your comments via the Comments page on this website so that they can be considered as part of this study.



View the Comment Form Send Us Your Comments

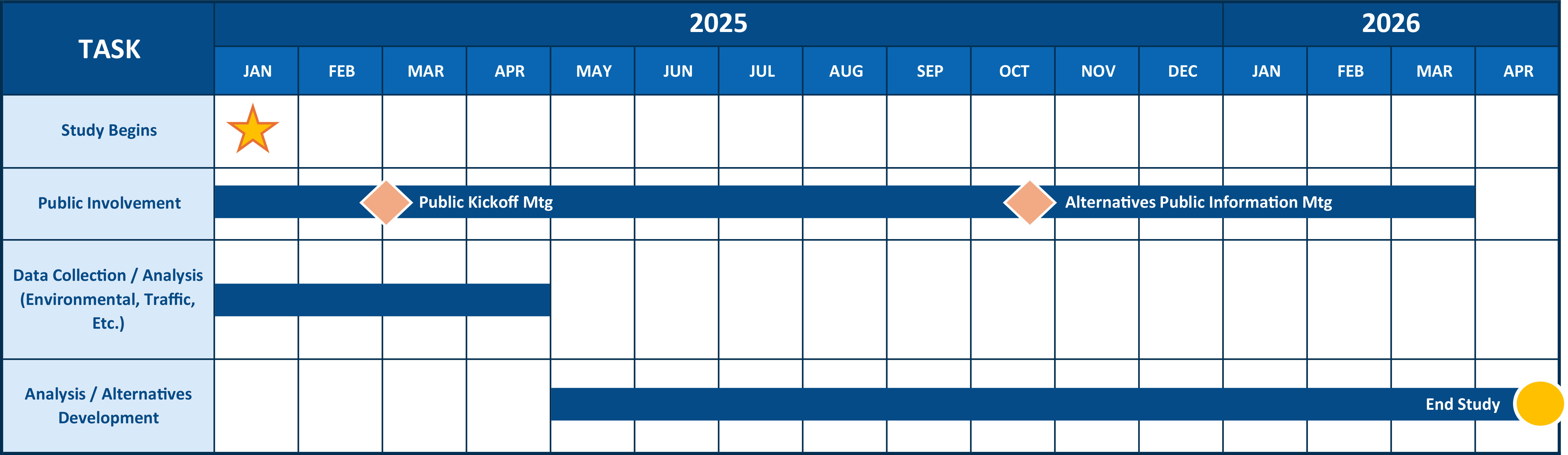

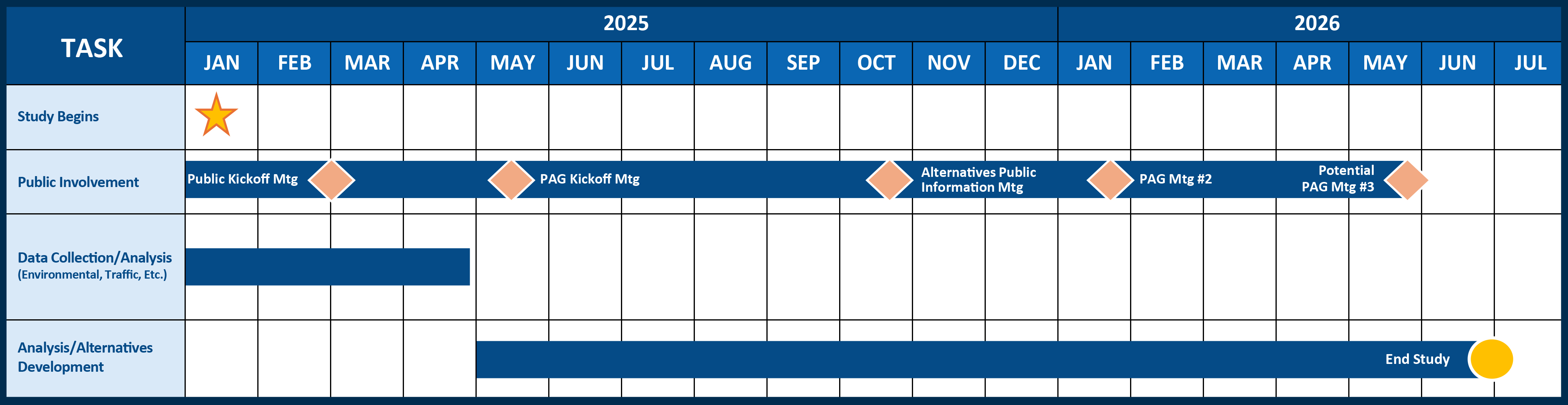

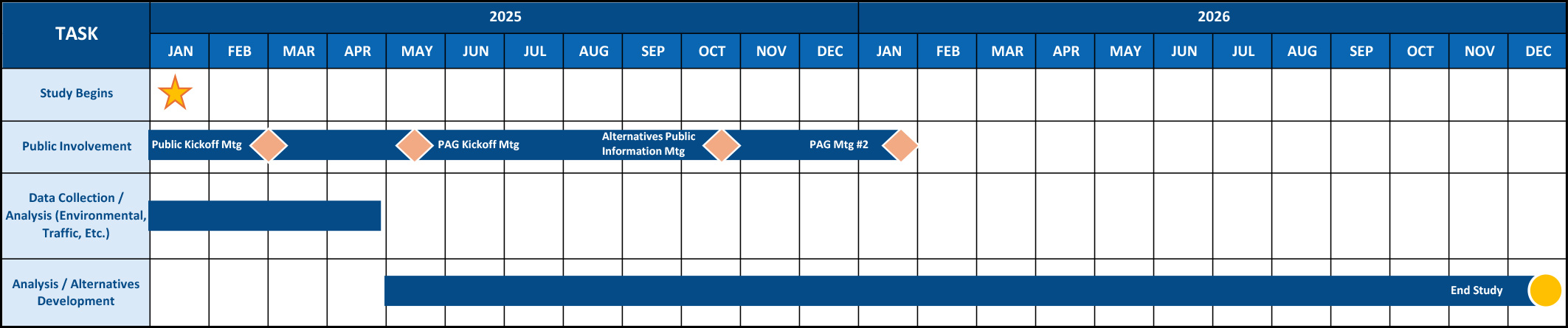

Project Schedule

The I-175 Action Plan began in January 2025, and is planned to be completed by the end of 2026.



View the Project Schedule View Project Schedule
